Onshore Wind Installation Services

Once your onshore wind site has secured the necessary consents, the next challenge is turning plans into a fully operational project. That’s where Renewables First can really help. We can deliver your entire wind installation – from project planning to final commissioning – or step in where you need extra expertise. With decades of renewable energy engineering experience, we combine technical excellence, project management and proven know-how to ensure your project is delivered on time, on budget, and to the highest standard.

Ready to start your onshore wind installation project? Contact us today.

Home » Services » Windpower » Wind Turbine Installation

Building onshore wind sites – what’s involved?

We typically manage the construction phase in three stages:

Stage 1 – Project Review & Outline Plan (≈1 month)

  • Review all project documentation (planning portal, grid offer, turbine procurement details, contractor agreements, etc.)
  • Identify outstanding requirements and integrate them into a clear project specification
  • Review planning consent conditions and prepare a plan to discharge them
  • Produce an initial project plan
  • Take on the CDM Principal Designer role and produce the initial Designer’s Risk Assessment

Benefit to you: Risks are identified early, giving you a clear roadmap and confidence to move forward.

Note: If Renewables First carried out the feasibility and consenting stages, this review will be relatively brief. If not, it will be more in-depth to ensure nothing is missed.

Stage 2 – Design, Specification & Procurement (≈4 months)

  • Produce a detailed site layout design, aligned with the planning consent

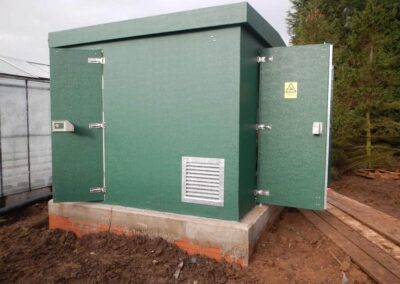

  • Complete onsite electrical (LV / 11 kV / 33 kV) and earthing system designs, plus lightning protection specification

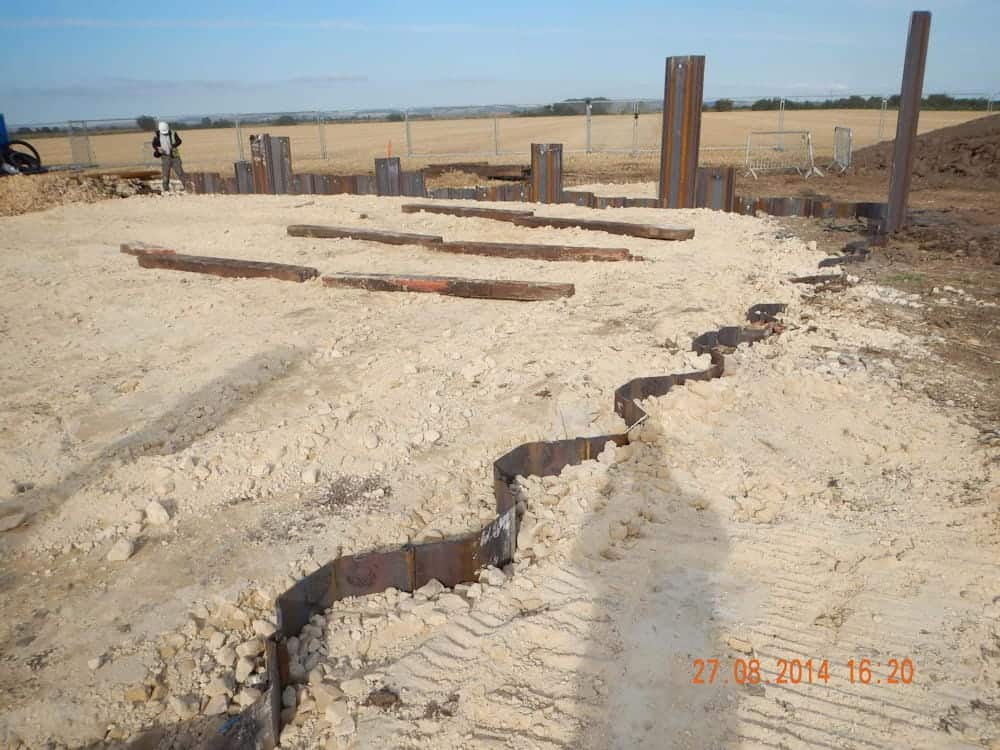

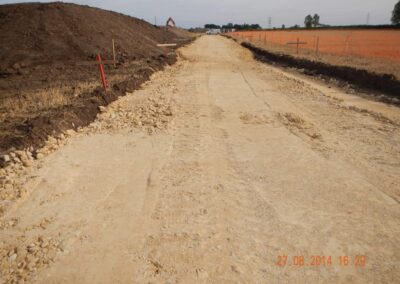

  • Specify and procure ground investigations and complete civils works designs (wind turbine foundations, substation bases, trenching, access roads, crane pads, etc.)
  • Manage tendering and procurement for civil, electrical, and DNO works

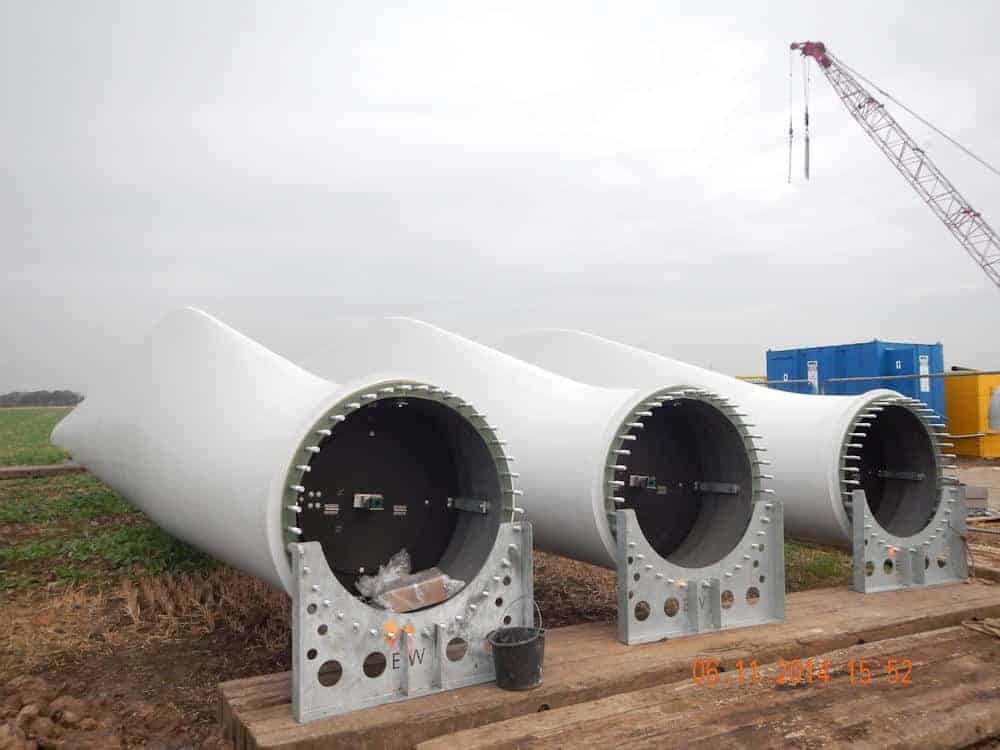

  • Procure the wind turbine and other hardware
  • Ongoing discharging of planning conditions, including Biodiversity Net Gain works
  • Update the project plan and risk assessments as required
  • CDM coordination

Benefit to you: Every detail is planned and procured in advance, ensuring smooth delivery and cost control.

Stage 3 – Construction, Installation & Commissioning (≈5 months)

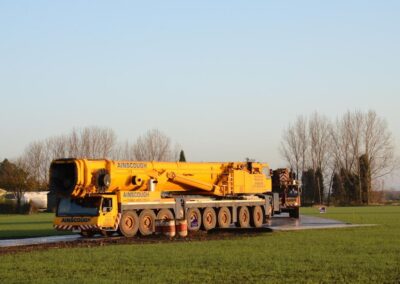

  • Oversee and manage all subcontractors and site works
  • Deliver civils works (foundations, substation, trenching, access roads, crane pads)
  • Manage installation of electrical systems (LV and HV, including client-owned 11 kV electrics)

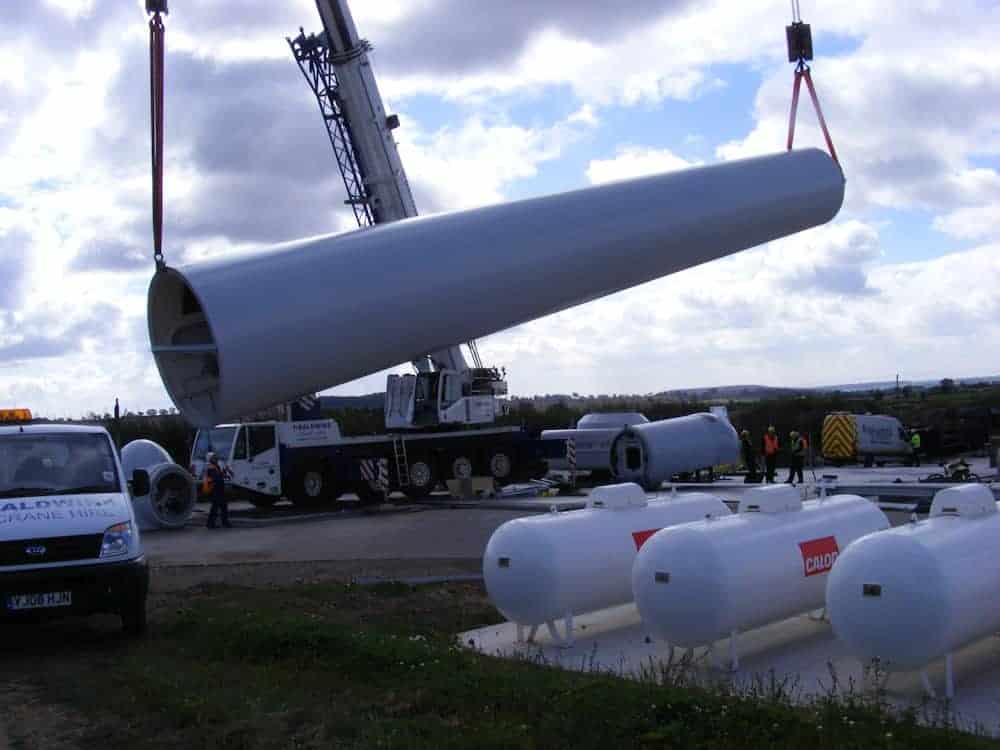

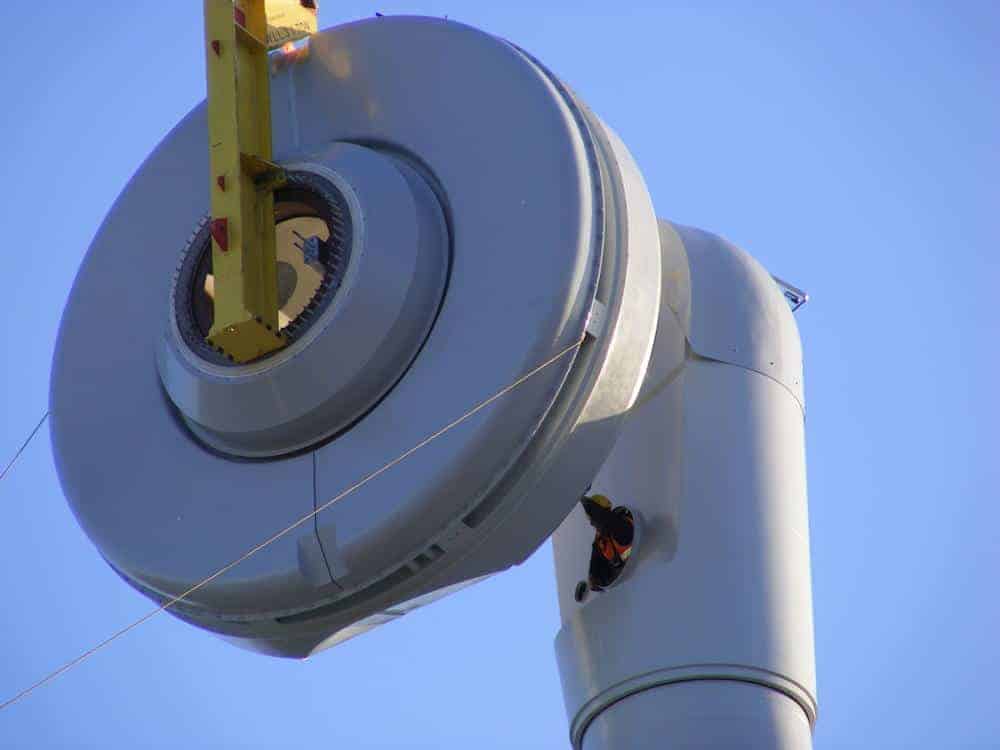

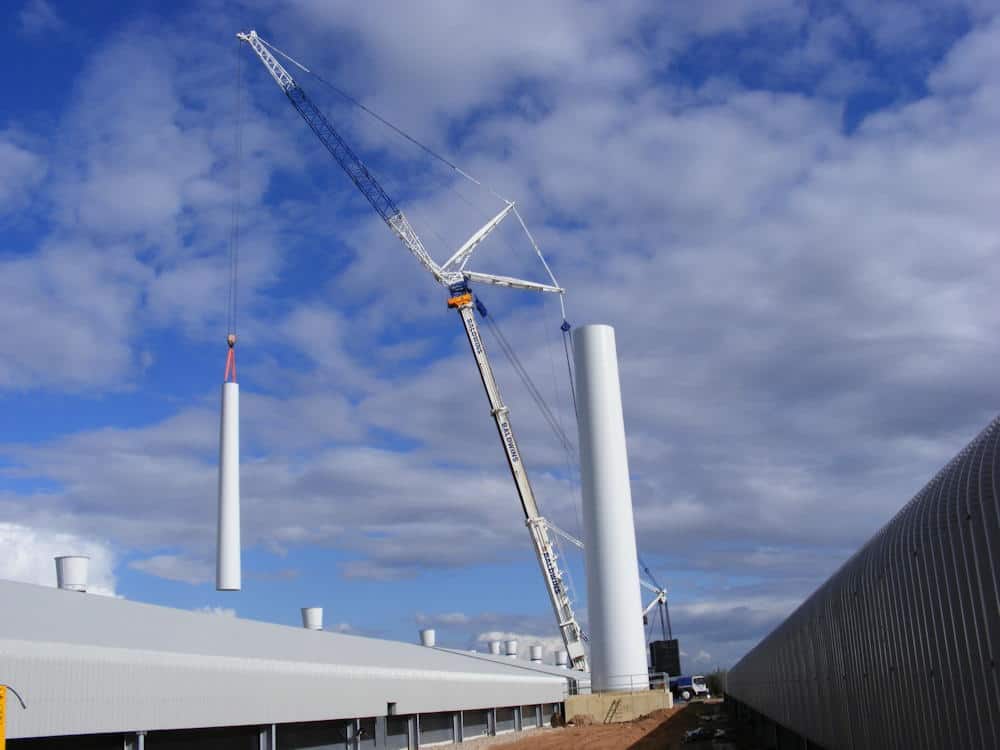

  • Coordinate with turbine supplier and the DNO for timely installation
  • Commission the grid connection (G99 / G100 compliance)
  • Finalise discharging of planning conditions and Biodiversity Net Gain works
  • Resolve technical issues as they arise and maintain overall project management
  • CDM coordination

Benefit to you: We take responsibility for every aspect of construction and commissioning, ensuring your turbines are installed safely, efficiently, and are ready to generate.

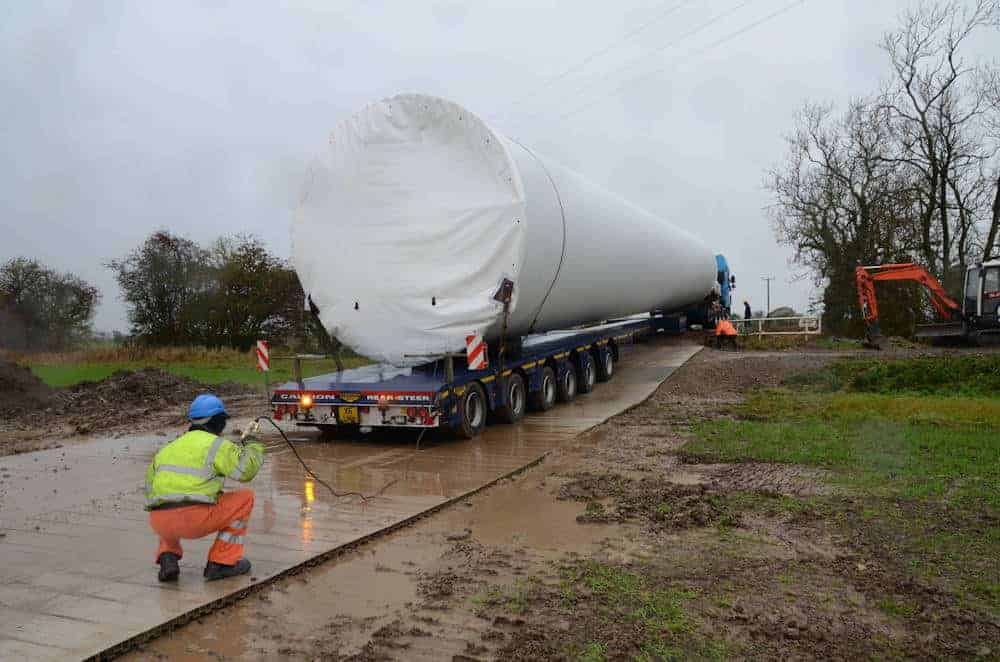

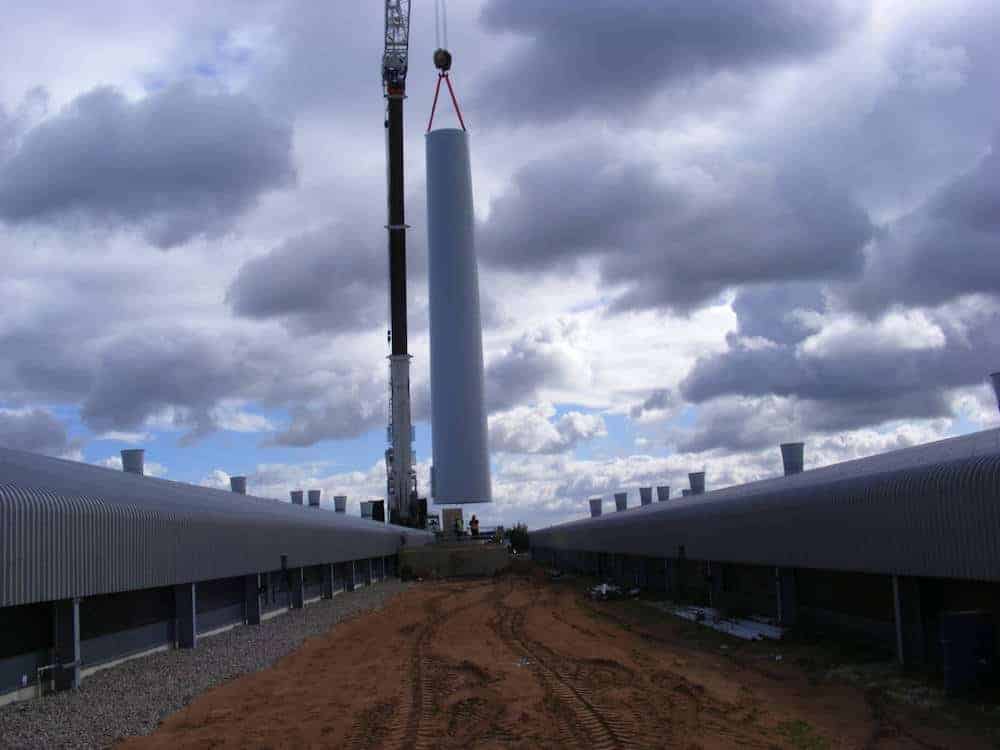

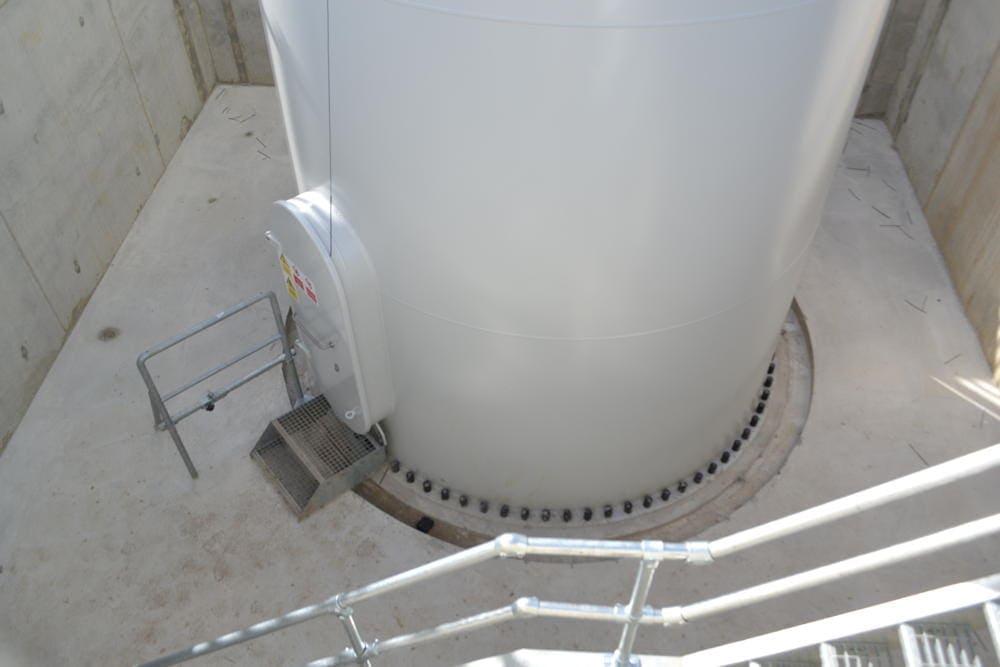

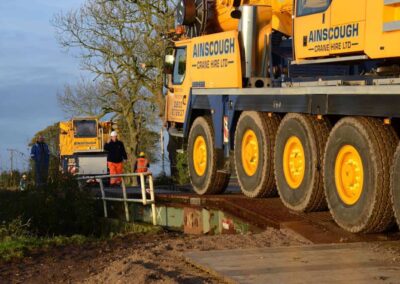

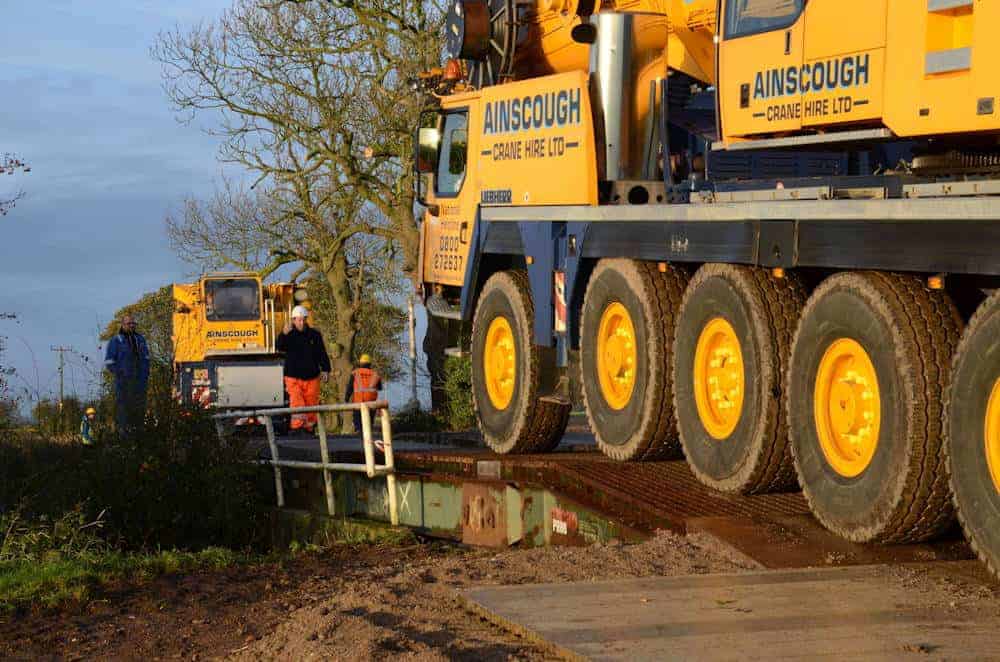

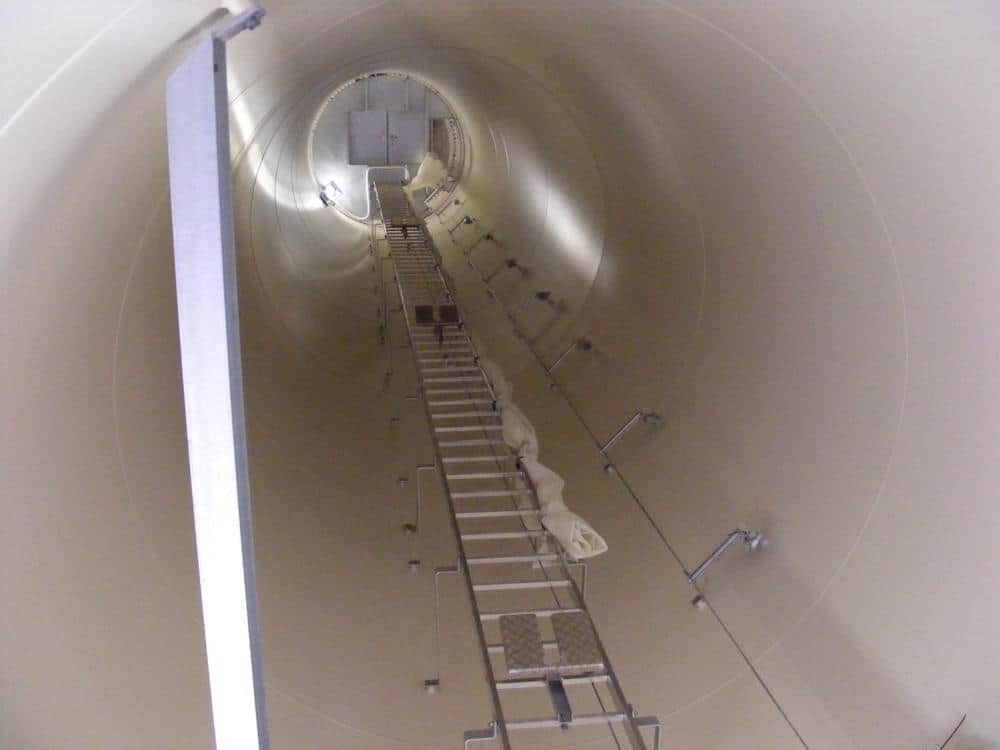

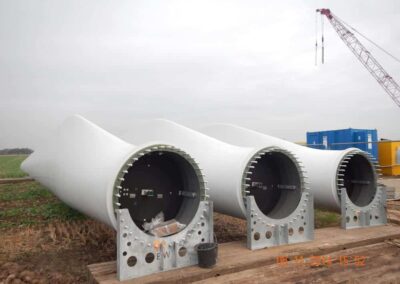

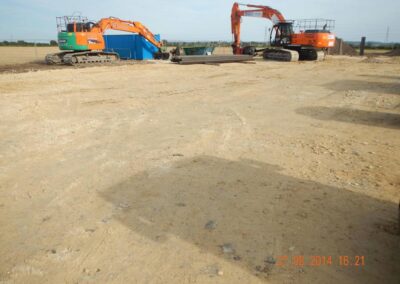

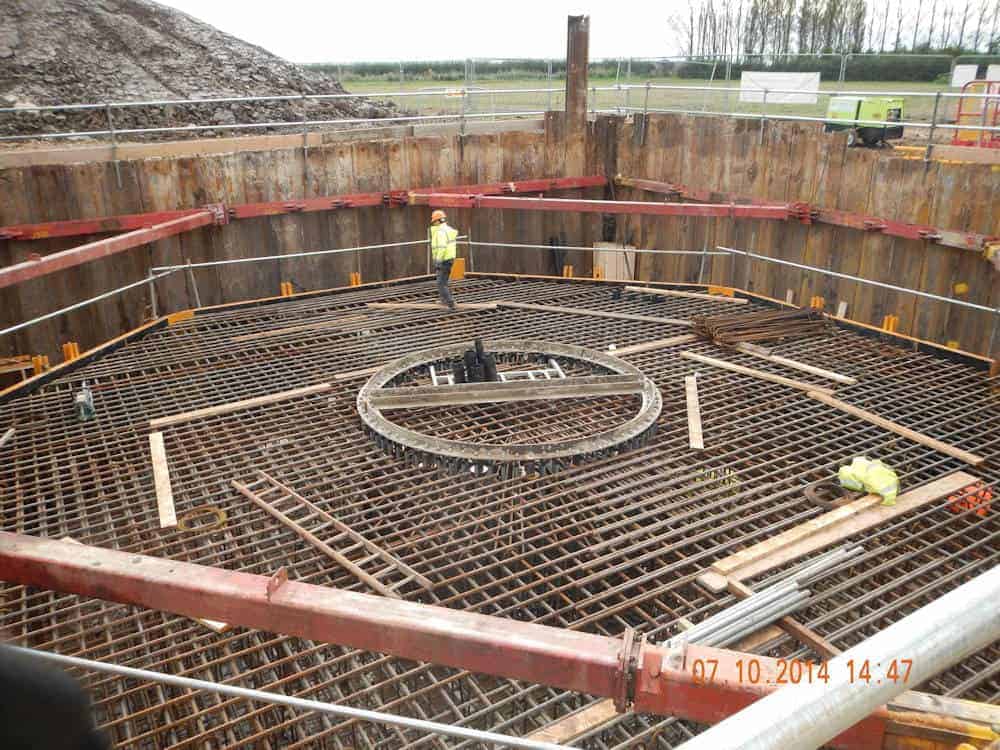

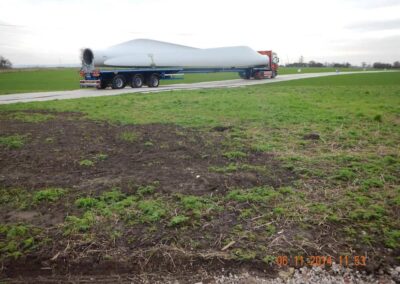

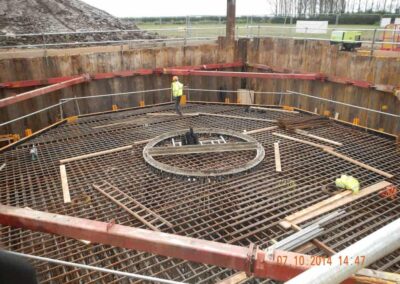

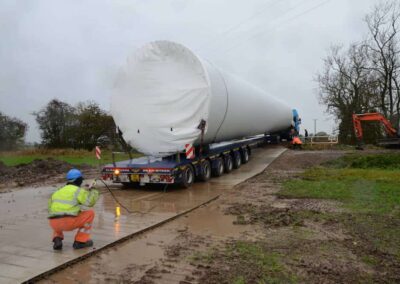

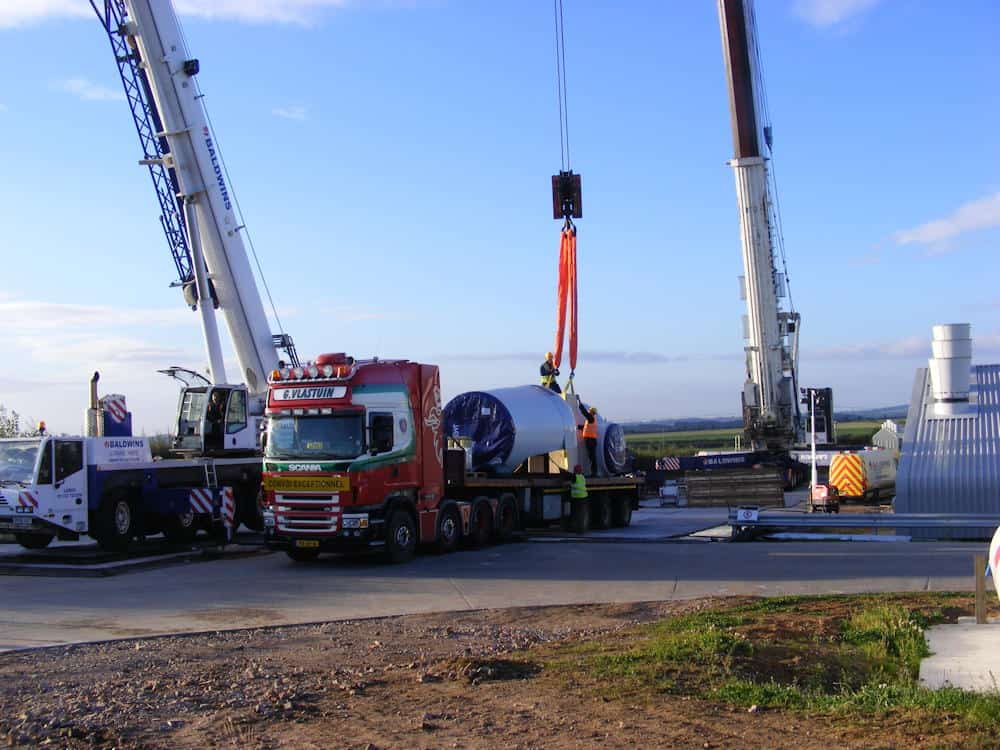

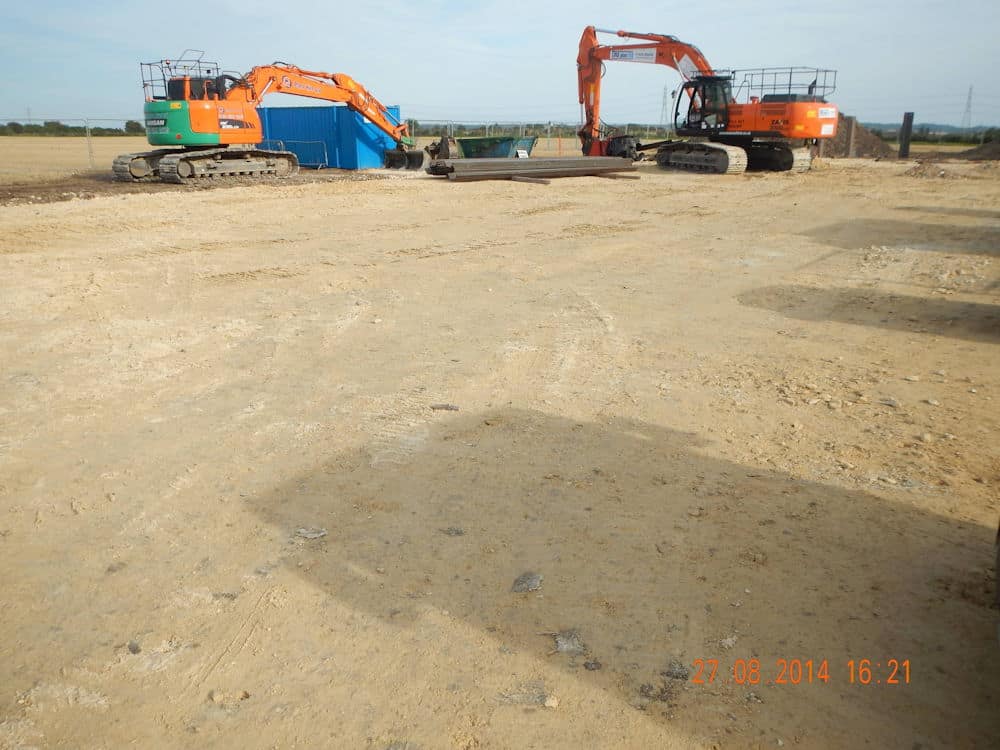

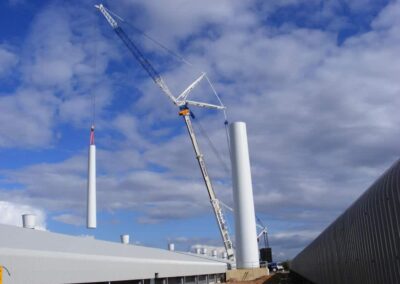

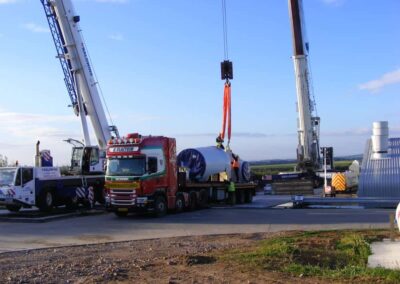

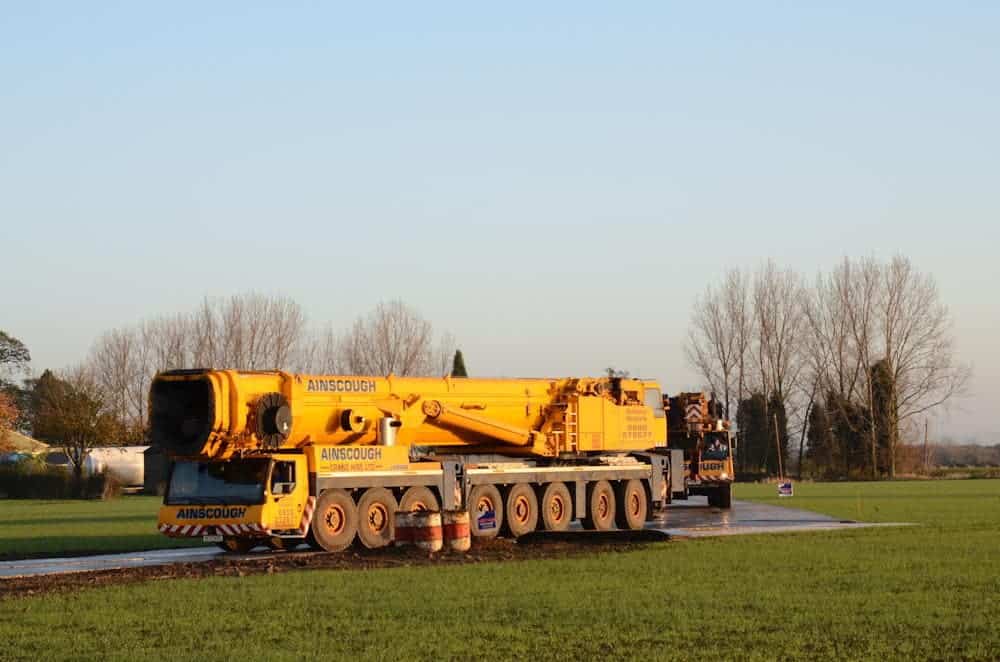

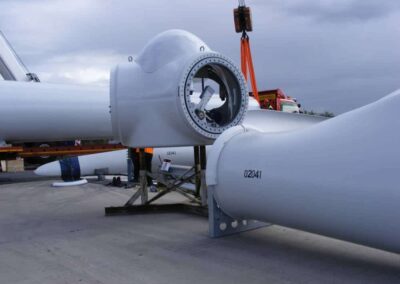

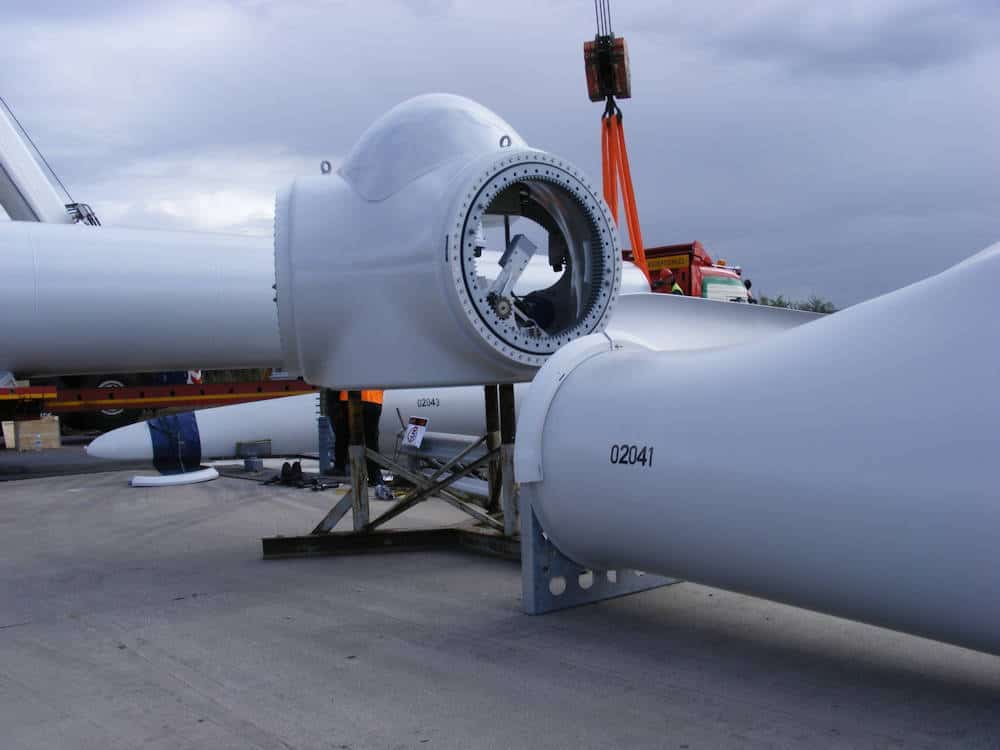

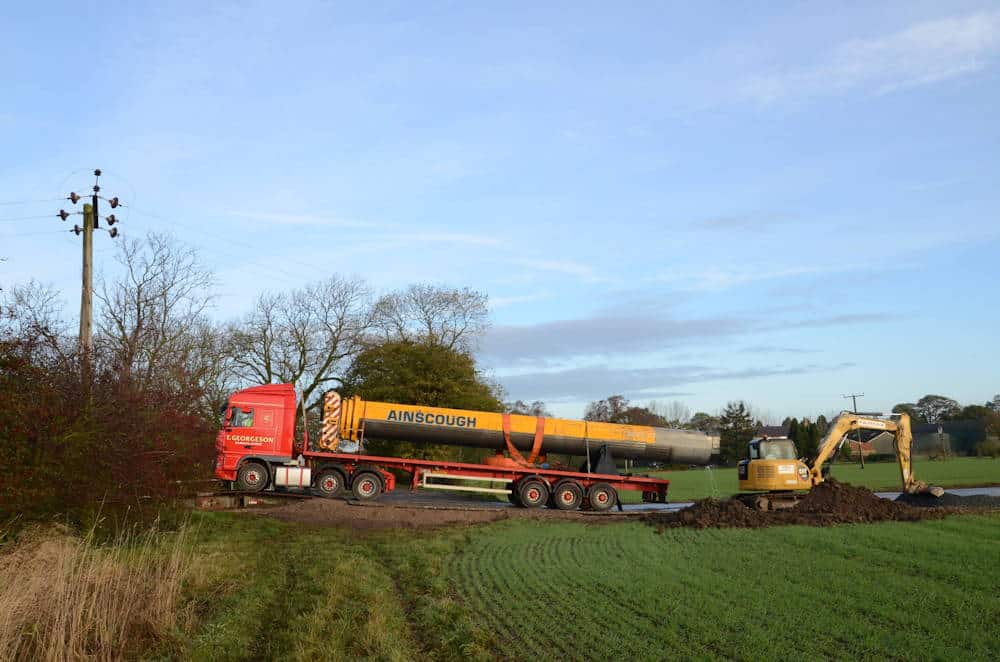

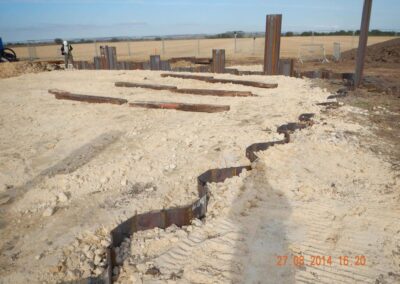

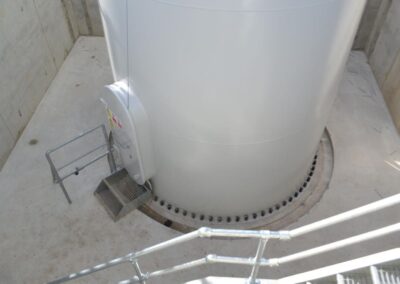

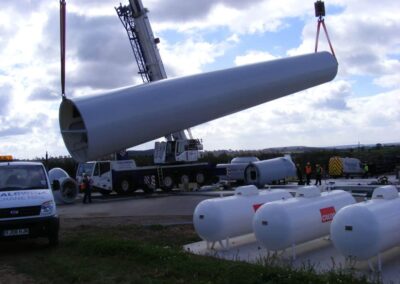

Construction sequence for a typical onshore wind turbine installation

Why Choose Renewables First?

  • Proven expertise – Decades of renewable energy engineering experience and successful project delivery
  • Complete service – From feasibility studies to commissioning, or just the parts you need
  • Peace of mind – We handle the complexity, so you can focus on the bigger picture

Take the next step: Contact us today to discuss your onshore wind installation project and find out how we can help bring it to life.

Our Clients

Renewables First works with commercial businesses, farms, industrial operators and landowners across the UK to deliver high-performing renewable energy projects.

We do not just produce reports. We design, build and operate renewable energy systems that generate measurable results.

Landowners, Farmers and Estates

Commercial Clients

Utility Companies

Community Groups

Local Authorities

Investors

Private Residences

Educational Institutions

Conservation Groups

Landowners, Farmers and Estates

Commercial Clients

Utility Companies

Community Groups

Local Authorities

Investors

Private Residences

Educational Institutions

Conservation Groups

We don’t just talk and write reports – we actually build stuff!

Our Windpower Projects

Here are some examples of past Windpower projects.
wind turbine case study

Blacktoft Nursery, 500 kW EWT DW54 Wind Turbine

Feasibility, design, consenting and construction. Directly supplying an enormous commercial greenhouse.

Hibaldstow Farm 500kw EWT wind turbine project

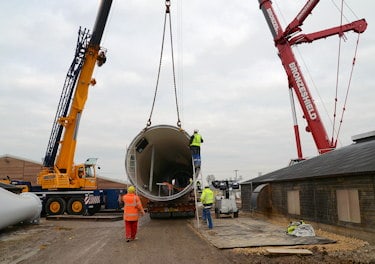

Hibaldstow Farm, 500 kW EWT DW54 Wind Turbine

Design, project management and delivery. Supplying the chicken farm with electricity and surplus exported to the grid.

Baulker farm 500kw wind turbine on chicken farm

Baulker Farm, 500 kW EWT DW54 Wind Turbine

Complex integration of a large wind turbine into a constrained site with power used to supply the chicken farm.

Want to Learn More?

We often hear the same key questions from clients — here are some of the most important ones, with links to in-depth answers in our Learning Centre.

Other Renewable Services we offer

Energy Storage Systems

For better alignment of your generation and demand profiles, and making best use of Time-of-Day electricity pricing

Heat Pumps

Specialists in water-source heat pumps and heat extraction from water courses, particularly rivers

Consultancy

Decades of experience of complex analysis, design, consenting and construction. We know how to solve problems, or avoid them completely

Solar PV

Large roof-top, ground-mounted, solar carports and floating solar, 50 kW to 5 MW+

Hydropower

Low, medium and high-head schemes and all turbine types, 25 kW to 2 MW+
